Pallet Racking Shipping Lead Times And Delivery Planning

A warehouse with pallet racks, a truck being loaded, and a clipboard chart. Text highlights pallet racking shipping lead times with tables listing estimated shipping times for different racking systems.

Planning a warehouse project means you have one big question: how long until your pallet racking actually shows up? The short answer is it can range from a few days for standard, in-stock items to several weeks or even months for highly customized, engineered systems.

The biggest factor, by far, is whether you are getting something off the shelf or ordering a custom-built solution. The good news is that the massive supply chain headaches of the last few years have largely settled down, bringing much needed predictability back to delivery schedules.

What To Expect For Pallet Racking Lead Times Today

Figuring out your project timeline is crucial, and let’s be honest, the racking is the main event. Getting from “order placed” to “racking on-site” involves a few key stages: order processing, engineering (if it is a custom job), manufacturing, and finally, shipping. Knowing these steps helps set a realistic baseline.

The easiest way to think about it is like buying a car. A standard teardrop pallet rack is the equivalent of driving a popular model right off the dealership lot. It’s mass produced, and distributors often have it ready to go. On the other hand, an engineered system—like a complex pick module or a rack designed for a seismic zone—is like special ordering a car from the factory with all the custom bells and whistles. It requires dedicated design and manufacturing time just for you.

A tablet displaying a lead time guide rests on a wooden pallet in a spacious warehouse aisle.

A Baseline For Your Project Timeline

It’s worth remembering how much things have improved. During the post pandemic supply chain crunch, average lead times in North America shot up by 45%. It was not uncommon to wait 20 to 24 weeks for even standard racking.

By focusing on domestic manufacturing and smarter inventory management, we have helped get those timelines back to normal. Today, the average wait for most in stock configurations is a far more reasonable 6 to 8 weeks.

To give you a clearer picture, we have put together a quick reference table with some common lead time estimates. Keep in mind these are just ballpark figures; your project’s complexity, current market demand, and other factors can shift the timeline.

If you need racking immediately, your best bet is to check out our selection of quick ship pallet rack options that ship in one business day.

Estimated Lead Times for Common Pallet Racking Systems

This table gives you a general idea of what to expect for different racking types, from the day you place your order to delivery.

Racking System Type Typical Lead Time (In-Stock) Typical Lead Time (Custom Order)
Standard Selective/Teardrop 1-10 Business Days 8-12 Weeks
Drive-In / Drive-Thru Racking 4-6 Weeks 12-16 Weeks
Pallet Flow / Carton Flow 4-8 Weeks 14-18 Weeks
Push Back Racking 4-8 Weeks 12-16 Weeks
Cantilever Racking 2-4 Weeks 10-14 Weeks

Having these general timelines in your back pocket makes it much easier to coordinate with installers and keep operational downtime to a minimum. For a precise schedule tailored to your exact needs, the best first step is always to talk to an expert.

Ready to lock in a timeline for your project? Contact Us for a free, no obligation quote and layout design. Our team can give you an accurate estimate based on what you are looking to build.

The Hidden Factors That Shape Your Delivery Timeline

It’s tempting to think your racking timeline starts the day you place an order. But in reality, several critical steps have to happen long before a single beam is loaded onto a truck. The final delivery date is a complex dance between raw material supply, precision engineering, and logistical realities.

Think of it like building a house. You do not just order lumber and start hammering. You need an architect to draw up blueprints, source the right materials, and get permits from the city. Each of those steps has its own timeline. Outfitting your warehouse works the exact same way. Understanding these behind the scenes factors lets you plan ahead and ask the right questions from the get go.

Material Sourcing And Availability

Your pallet rack’s journey starts with raw steel. It’s the foundation of almost every component, and its availability and price can swing based on market conditions, directly impacting pallet racking shipping lead times.

This is one area where we give our clients a serious advantage. We are committed to sourcing our steel from North American suppliers. This keeps our supply chain stable and predictable, sidestepping the massive headaches of international shipping delays, port gridlock, and tariffs that can tack on weeks or even months to a timeline. A domestic supply chain is simply more resilient and reliable.

By prioritizing domestic steel, businesses can often reduce raw material lead times by up to 40% compared to relying on overseas imports, providing a significant buffer against unforeseen global disruptions.

Customization And Engineering

If your project needs anything beyond standard, off the shelf parts, we move into an essential engineering phase. This is where our experts get to work, turning your operational needs into a safe, efficient, and code compliant racking system.

This phase is absolutely non negotiable for projects that involve:

  • Unique Load Calculations: Making sure the rack can safely handle the exact weight and dimensions of your products.
  • Seismic Zone Requirements: Designing the system with added structural muscle to meet strict local building codes in earthquake prone areas.
  • Specialized Configurations: Laying out complex systems like pick modules or integrating racking with automated conveyor systems.

Just like an architect has to finalize blueprints before a foundation is poured, our engineers must complete and approve all drawings before a single piece of steel is cut. To speed this up, our team offers free pallet rack design services, turning your requirements into actionable plans without the long wait. Getting the design right upfront saves a fortune in time and money down the road.

Manufacturing Capacity And Backlog

A supplier’s production schedule is a huge piece of the puzzle. Every manufacturing plant has a limited capacity, and your order has to get in line. If you order during a peak season or when the manufacturer is already swamped with a backlog of jobs, your lead time will naturally be longer.

This is where planning ahead pays off. The businesses that talk to us early in their process are the ones who secure their spot in the production queue. A little foresight helps you dodge the rush and lock in a manufacturing window that aligns perfectly with your installation schedule. Proactive planning is the single best way to navigate production bottlenecks and keep your project on track.

Freight Logistics And Municipal Permitting

Finally, there are two hurdles that catch people by surprise all the time: freight and permits. Once your racking is built, it has to get to you. That involves coordinating trucks, booking carrier space, and planning transit routes, which can add anywhere from a few days to over a week depending on the distance and freight availability.

Even more critical, most cities and counties require permits for new pallet rack installations, especially for systems over a certain height or in seismic zones. The permitting process can be a real drag, sometimes taking 4 to 8 weeks or even longer. It involves submitting engineered drawings to the local building department and waiting for their stamp of approval. This happens completely separately from the racking lead time and must be factored into your project plan. Otherwise, you’ll have trucks full of racking arriving at a site where you cannot legally start the work.

A Realistic Timeline For Different Racking Systems

Not all pallet rack and pallet rack systems are created equal, and you can bet their lead times are not either. Getting a handle on what to expect for your specific system is one of the most important first steps in planning a successful warehouse project. The timeline can swing wildly, from just a few days for common components to several months for complex, custom engineered solutions.

So, why the big difference? It really comes down to how they are made. Think of a standard selective rack like a high volume, mass produced item. Manufacturers churn these out constantly and keep them in stock, ready to go. That is why you can often get standard teardrop racking delivered in a fraction of the time it takes for a more specialized system.

Standard Selective Racking Timelines

For your everyday, standard selective pallet rack, the timeline is almost always the shortest. Since it is the go to racking in warehouses all over North America, the parts are usually sitting on a shelf somewhere, waiting for an order.

  • In-Stock Orders: If you need common sizes of uprights, beams, and wire decks, you are in luck. Expect delivery within a brisk 1 to 10 business days.
  • Larger or Non-Stock Orders: Need a massive quantity or some less common sizes? That might require a dedicated manufacturing run, extending the lead time to a more typical 8 to 12 weeks.

The biggest plus here is predictability. High availability means less guesswork and a much more reliable schedule for your installation crews.

Engineered Systems: Push-Back, Drive-In, And Pallet Flow

This is where pallet racking shipping lead times get a bit more involved. Engineered systems—like push back, drive in, or pallet flow—are not something you can just pull off a shelf. Each one is designed from the ground up for your specific needs, factoring in your product loads, facility layout, and unique workflow.

This level of customization adds a few necessary steps to the process:

  1. Detailed Engineering: Our designers get to work, creating precise drawings based on your product weight, pallet dimensions, and how you move inventory.
  2. Custom Fabrication: The specialized parts, like carts, rails, and braking systems, are then manufactured to the exact specifications from those approved drawings.
  3. Component Integration: Finally, all the custom and standard parts have to be coordinated for production and shipping.

Because this is a bespoke process, the lead times are naturally longer. You should generally plan for a timeline of 12 to 18 weeks from the moment you approve the final designs to the day the trucks arrive. For highly complex projects, like a multi level pick module, the timeline could stretch even further.

This infographic helps visualize the key phases that build up to that final delivery date.

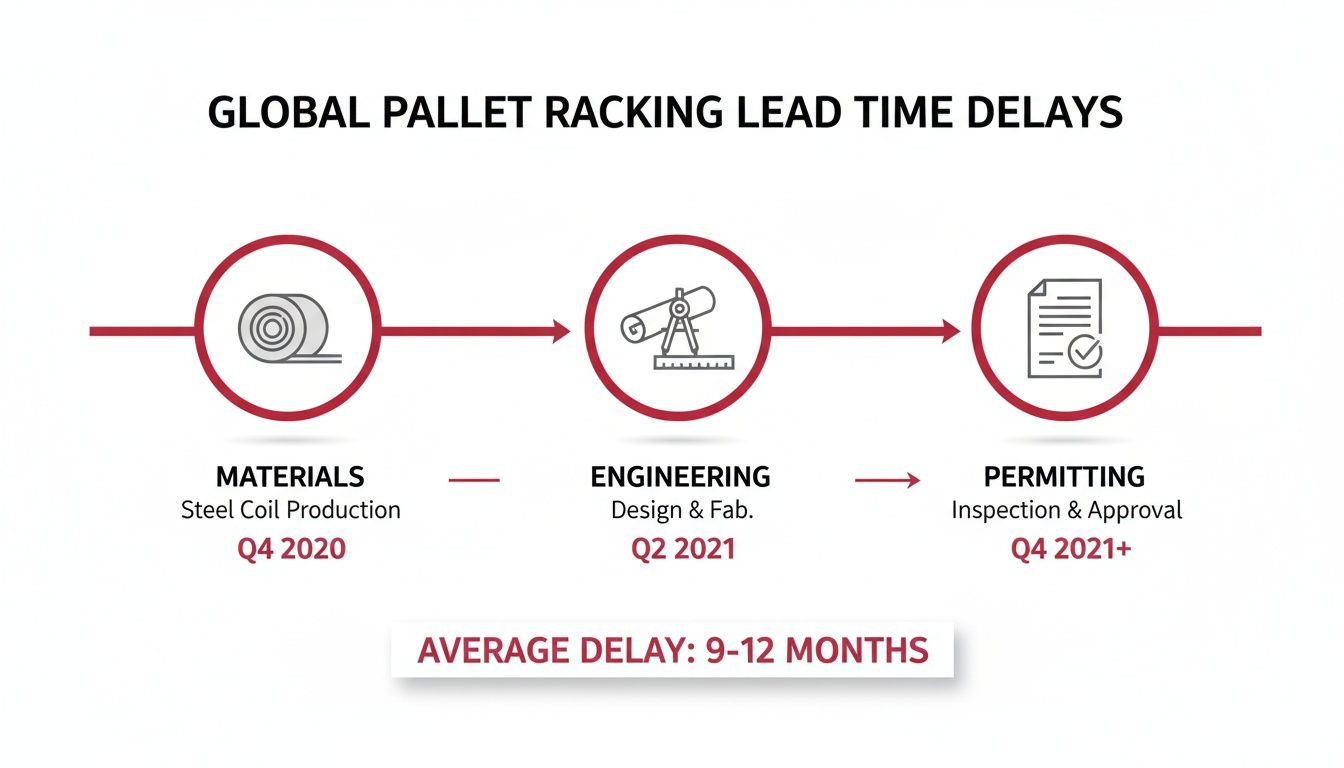

Infographic illustrating global pallet racking lead time delays across material production, engineering, and permitting, showing average 9-12 month delays.

As you can see, things like material sourcing, engineering approvals, and permitting each add their own block of time that you absolutely have to account for in your project plan.

The North American Manufacturing Advantage

Where your racking comes from really matters. When you look at the data, you see a major difference in shipping timelines based on region. Right now, North America has some of the shortest average lead times in the world, usually around 4 to 8 weeks, which is a huge improvement over the 12 to 16 weeks common in other global markets.

This speed is mostly thanks to a well oiled logistics infrastructure and a reliance on domestic steel, which helps us sidestep the long, unpredictable delays that can plague overseas imports. By prioritizing North American manufacturing, we give our customers more reliable—and often faster—timelines. It cuts down the risk of international shipping headaches and gives you much better transparency from start to finish.

Let’s take a look at how these timelines play out in a real world project scenario.

Project Phase Timeline Comparison

The table below breaks down how different project phases contribute to the total lead time for both a standard, off the shelf system and a fully custom one. It is a great tool for visualizing the entire process and setting realistic expectations from the get go.

Project Phase Standard Racking Timeline Custom Racking Timeline
Initial Consultation & Quote 1-3 Business Days 3-7 Business Days
Design & Engineering N/A (Standard Components) 2-4 Weeks
Permit Application & Approval 2-6 Weeks 4-10 Weeks
Manufacturing & Fabrication 1-2 Weeks (If not in stock) 6-10 Weeks
Freight & Delivery 1-10 Business Days 1-2 Weeks
Installation 1-2 Weeks 2-4 Weeks
Total Estimated Lead Time 4-10 Weeks 15-27 Weeks

As you can see, the custom engineering and fabrication phases are the biggest differentiators, adding significant time to the project. Planning for these upfront is the key to keeping your project on track and avoiding last minute surprises.

Strategies To Proactively Manage Your Project Timeline

Knowing the variables that affect pallet racking shipping lead times is half the battle. The other half is actively taking control of your project’s schedule. A few proactive moves can help you sidestep common delays and steer your project toward a smooth, predictable finish.

Hands holding a tablet showing a calendar, with shipping boxes and a warehouse in the background.

This is not about rushing blindly; it is about smart, forward thinking planning. By tackling key milestones early on, you secure your spot in production schedules and avoid the bottlenecks that can derail even the most well thought out plans. The smoothest installations always belong to the businesses that plan ahead, turning potential headaches into simple checklist items.

Engage Early for Design Assistance

One of the best ways to shorten your overall project timeline is to start the conversation early. Bringing a supplier in for design assistance can shave weeks off the front end of your project. Instead of trying to reinvent the wheel internally, you get to tap into expert knowledge from day one.

Our team provides free pallet rack design services with no strings attached. This collaborative approach helps you:

  • Finalize Layouts Faster: We turn your operational needs into efficient, compliant layouts—fast.
  • Avoid Engineering Revisions: Getting the specs right the first time prevents the costly and time consuming back and forth that stalls production.
  • Identify Long-Lead-Time Items: We can flag any custom components early, letting you build their specific timelines right into your master schedule.

Finalize Specifications Promptly

Once you have a design proposal, locking in your layout specifications is the next crucial move. Any hesitation or change at this point can create a ripple effect, pushing back engineering, manufacturing, and delivery. A firm layout is what allows the engineering team to produce the stamped drawings needed for both manufacturing and your permit application.

Quickly approving those drawings is what officially gets your project into the production queue. The businesses that make decisive plans are the ones that see their materials arrive on schedule, ready to go.

Investigate Permitting and Coordinate Installation

Two major hurdles often get overlooked until it is almost too late: municipal permits and scheduling an installation crew. You need to be looking into your local building department’s permitting requirements long before your materials are set to arrive. This process alone can easily take several weeks, and you legally cannot start installation without an approved permit.

At the same time, get in touch with your installation team. Give them a copy of the final layout and the estimated delivery date so they can block out time and resources. Aligning your installers with the material delivery means they can hit the ground running, preventing your brand new racking from sitting idle and hogging valuable floor space.

By aligning permitting applications with the manufacturing timeline, project managers can prevent an average of 4 to 6 weeks of on-site delays, ensuring installation can begin the moment materials arrive.

By taking these strategic steps, you shift from being a passive observer to an active manager of your timeline, guiding your project to a successful and timely completion.

Ready to start planning? Request a Quote and get a free layout design to kickstart your project on the right foot.

How We Keep Your Pallet Racking Project On Track

Getting your facility up and running on time is everything. We get that. That is why our entire process is built from the ground up to sidestep the common delays that can sink a project timeline. It all comes down to a simple, effective foundation: massive in-stock inventory, expert design support, and rock solid freight partnerships.

The biggest headache we solve for our clients is the waiting game for materials. Our huge selection of ready to ship industrial pallet rack components is our secret weapon. This turns what is often a multi week wait from other suppliers into just a few days, which is a total game changer when you need to expand or replace racking without bringing your whole operation to a halt.

Free, No-Obligation Design Services

When your project is more complex than just standard parts, our in-house design team is ready to jump in. We offer free, no obligation pallet rack design services to turn your rough ideas into a workable, efficient plan—without the long back and forth you might expect.

Our specialists handle all the tricky parts for you, from load calculations to making sure the final layout is up to code. By nailing the design right from the start, we prevent those expensive revisions and frustrating delays that can derail a project down the line. It is all about a proactive approach that ensures your project begins on solid footing.

A well-planned design phase can cut total project time by up to 25%. Getting it right upfront eliminates the engineering churn and ensures every single component is correctly specified before an order is even placed. That initial time investment pays off big time with a smoother, faster installation.

Leveraging Strong Freight Relationships

Once your racking is ready to go, the final hurdle is getting it to your facility on time. This is where our long term relationships with a network of trusted freight carriers across the country really shine. This network gives us the power to lock in reliable delivery schedules at fair prices, even when things get hectic.

These partnerships mean we can:

  • Find available carriers quickly, even during peak shipping seasons.
  • Negotiate better freight rates and pass those savings directly to you.
  • Provide accurate transit time estimates, so you have a clear and reliable delivery window.

Our logistics expertise means you are not left scrambling to find a carrier or dealing with the fallout from an unexpected shipping delay. We manage the whole process to make sure your materials show up safely and right on schedule.

A Clear View of Modern Timelines

Understanding the current market is key to smart planning. The good news is that after some chaotic years, we’ve seen a significant stabilization in global lead times. While past disruptions caused delays of 50% or more, current data shows a much more predictable 5 to 10 week window for most standard projects. This shift, driven by smarter manufacturing practices, has been a huge help for scheduling warehouse expansions.

For our customers, this stability means more reliable project timelines. For instance, even specialized orders like pallet racking for pest control with security cages now typically arrive in just 4 to 6 weeks. You can learn more about these market trends in the full report from Fortune Business Insights.

Ultimately, our entire system is designed to remove friction from the procurement process. From a massive inventory ready to go, to expert design and reliable shipping, we deliver a seamless experience that respects your timeline.

Don’t let avoidable delays slow down your next project. Contact Us at (800) 326-4403 to talk through your needs and find out just how quickly we can get your warehouse operating at its best.

Your Partner In Efficient Warehouse Outfitting

When it comes down to it, pallet racking lead times have a lot of moving parts, but that does not mean they have to be a source of constant headaches. The secret to a successful, on-time project always comes back to two things: planning ahead and picking the right supplier. Once you get a handle on how things like custom designs, material availability, and freight logistics affect your schedule, you can start managing them instead of letting them manage you.

We have walked through the differences between standard and custom timelines and laid out some real world strategies to keep your project moving forward. The businesses that come out on top are always the ones that plan their needs well in advance, locking in production slots and dodging the seasonal rushes. That foresight is what makes for a smooth installation. Now, it is time to put our experience to work for you.

Start Building a More Efficient Warehouse

We help you get off the ground faster by streamlining those initial phases with our free, no obligation pallet rack design services. It’s the quickest way to get from a rough idea to a firm quote.

Our massive in-stock inventory of industrial pallet rack systems and competitive pricing means you get the quality materials you need, right when you need them. We pride ourselves on offering some of the fastest shipping and delivery in the industry, because we know that downtime is not an option.

When you partner with us, you’re not just buying steel; you are getting a dedicated team committed to pushing your project across the finish line on your schedule. The chance to optimize your facility and seriously improve your workflow is right here, right now. Securing your materials sooner is the best insurance against future delays.

Let’s start building a more efficient warehouse together. Request a Quote online to get your free layout and design, or give our specialists a call at (800) 326-4403 to talk through your project today. We’re ready to help you hit your operational goals.

Frequently Asked Questions About Racking Lead Times

When you are mapping out a big warehouse project, timeline questions are always front and center. Getting clear, no nonsense answers helps you manage expectations and line up everything from installation crews to operational schedules. We have pulled together the most common questions we hear from warehouse managers and buyers about pallet racking shipping lead times.

Think of this as your practical guide to planning your project with confidence and sidestepping the usual scheduling headaches.

How Far In Advance Should I Order My Racking?

Planning ahead is the single best thing you can do for a smooth installation. The right amount of time really depends on what you’re ordering.

For standard, in-stock systems like teardrop pallet racking, give yourself a buffer of 8 to 12 weeks. That is usually plenty of time to cover order processing, freight coordination, and getting your installation team on the calendar without feeling the pressure.

But if you are looking at a large scale project or a custom engineered system that needs special fabrication and city permits, you’ll want to start the conversation much earlier. We strongly recommend kicking things off 16 to 24 weeks before your target installation date. This longer timeline gives everyone breathing room for design tweaks, permit approvals, and manufacturing so your go live date stays on track.

Can My Pallet Racking Order Be Expedited?

We get this question a lot, especially when operational needs change on a dime. While we can often speed up the freight and shipping part of your order for an extra fee, the manufacturing and engineering timelines for custom systems are pretty much set in stone. Those schedules are locked in to make sure every single component meets strict quality and safety standards.

The fastest, most reliable way to get racking is to choose from our massive in-stock inventory. These systems skip the custom fabrication queue completely, letting us ship materials in a matter of days, not weeks.

If speed is what you need, our team can point you to the best in-stock options that meet your load requirements.

Does The Shipping Lead Time Include Installation?

This is a critical point: no, the shipping lead time does not include installation. That lead time covers the period from when your order is officially confirmed to the moment the materials land at your job site.

Installation is a completely separate phase of the project. You will want to schedule your install crew to start right as the racking arrives, or very shortly after. Lining this up perfectly is key to preventing your brand new racking from sitting on the floor, taking up space and risking damage.

What Information Helps You Provide An Accurate Lead Time?

The more details you can share with us upfront, the sharper our lead time estimate will be. To give you a timeline you can count on, our team needs to know a few key things about your project.

Having this info ready helps us check stock levels, factor in any engineering work, and calculate transit time right from the start:

  • Warehouse Layout Drawings: CAD files are great, but even a simple sketch of your space helps immensely.
  • Desired System Type: Let us know if you need selective, drive-in, push-back, or another type of industrial pallet rack.
  • Capacity Requirements: What’s the weight, size, and dimensions of the pallet loads you’re storing?
  • Final Delivery Address: Your zip code is the key to calculating accurate freight times.

With these details in hand, our specialists can build a reliable timeline you can plug right into your project plan.


At Material Handling USA, our entire goal is to make outfitting your warehouse as predictable and seamless as possible. We lean on a massive in-stock inventory and expert pallet rack design services to deliver solutions that work for your schedule.

Ready to get a firm timeline for your project? Request a Quote for a free layout and a precise lead time estimate, or just give us a call at (800) 326-4403.
