Mobile Shelving Installation: Process, Site Readiness and Sequence

What actually happens when a high-density system is installed — the site conditions that have to be true first, the order the work happens in, and the handover items worth insisting on.

Installed compact mobile shelving system with three-spoke handles in a records room

4

Readiness gates a room has to clear first

1

Pre-installation conference that prevents most surprises

Rail first

Everything else is set out from the rail

Handover

Testing, adjustment and demonstration are part of the work

Installation is short. Readiness is what takes the time

People searching for shelving installation usually want to know how long a crew will be in the room. That is almost never the number that decides the project. On a compact system the on-site work is comparatively quick and highly predictable — provided the room, the floor and the structure are in the condition the shop drawings assumed. When installations go badly, it is nearly always because something in that assumption was never verified.

Unlike static shelving, a track-mounted mobile shelving system is an assembly that has to move accurately for the next twenty years. Its carriages roll on rails that are set out to fine tolerances, anchored to structure and levelled across the whole run. A floor that is out of tolerance, a recess cut to the wrong depth, or a room that still has trades working in it does not produce a slightly worse installation; it produces a system that binds, drifts or cannot be commissioned at all.

This page describes what installation involves, what has to be true before it starts, and what a competent handover looks like. It is written to be useful whether you are the facilities manager who will live with the system, the contractor coordinating trades, or the specifier trying to write realistic sequencing language. If the system already exists and is moving to a different room or building, see moving or reusing an existing mobile shelving system instead — the sequence and the reusable components are different.

Hand-drawn plan of a warehouse layout showing mobile shelving ranges, aisles and material flow
An installation delivers what the layout promised only when the room, the floor and the structure match the drawing it was set out from.

Four gates before an installation date means anything

Published specifications for manual mobile storage shelving describe an examination step in which the installer, with the owner present, verifies floor surfaces against the installation tolerances, confirms the building structure is adequate for the units at the locations shown on approved shop drawings, and confirms that the intended positions will not block required means of egress. That examination is not a formality. Treat it as four gates, each of which can be closed on paper long before a crew is scheduled.

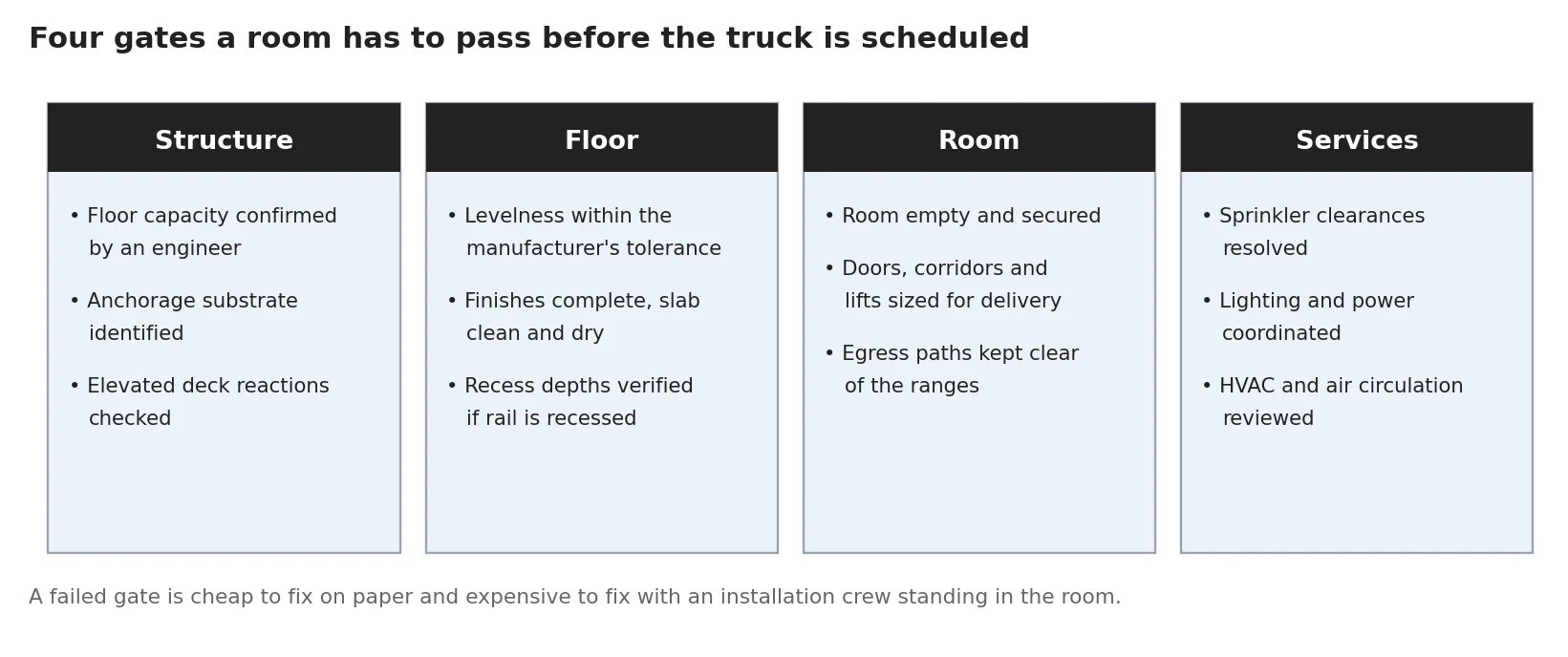

Diagram of four site readiness gates: structure, floor, room and services
Every one of these is cheap to resolve during design and expensive to discover with an installation crew standing in the room.
Gate What has to be confirmed Who normally confirms it
Structure Floor capacity for the loaded configuration, anchorage substrate, and reactions on elevated construction. A licensed structural engineer, using the manufacturer’s reaction loads.
Floor Levelness within the manufacturer’s tolerance, finishes complete, slab clean and dry, recess depths correct where rail is recessed. Installer’s floor survey, coordinated with the general contractor or facilities team.
Room Room empty and secure, delivery route sized for the components, egress paths unobstructed by the proposed layout. Owner or contractor, verified against the approved shop drawings.
Services Sprinkler clearances, lighting positions, power for powered systems, and air circulation over compacted ranges. Design team, with the fire protection engineer for anything touching the sprinkler system.

Scheduling language worth using

Published mobile storage specifications call for installation to commence after finishing operations, including painting, have been completed, and for a pre-installation conference on site to review levelness of flooring and preparatory work performed under other contracts. Both requirements exist because trades working over a set rail run is a reliable way to lose the tolerance.

Floor-preparation checklist for mobile shelving rail installation: flatness, levelling, anchorage, and capacity
The rail run is the datum for the whole system. Everything above it inherits whatever error the floor introduced.

The floor survey is the real gate

Of the four gates, the floor is the one that most often fails, because “the floor looks fine” is not a measurement. Concrete floors are specified and measured for flatness and levelness using F-numbers under ASTM E1155 and the tolerance framework in ACI 117 — flatness describing how bumpy or wavy the surface is, and levelness describing how level it is overall. Published guidance on the F-number system explicitly notes that floor levelness affects shelf placement and design.

What matters for your project is simpler than the standards: the manufacturer of the system you are buying publishes an installation tolerance, and the floor either meets it or it has to be corrected. The correction is normally shimming or grouting the rail rather than anything done to the slab, but the scope and cost of that correction depend entirely on how far out the floor is and over what distance.

Get the survey done early. A floor survey during design costs very little and changes the rail approach, the budget and sometimes the layout. The same survey done on installation day changes the schedule.

  • Ask the manufacturer for the written installation tolerance before the floor is assessed, not after.
  • Survey along the intended rail lines, not just at a few random points in the room.
  • For an existing building, check for slab curl at joints, previous patching, and floor coverings that will be removed.
  • Confirm what happens at the ends of the rail run, where levelling errors tend to accumulate.
  • Agree in writing who is responsible for correcting an out-of-tolerance floor before it is discovered.

The order the work actually happens in

A compact storage installation is a linear process. Almost nothing can be done out of order, because every stage inherits the accuracy of the one before it.

Bar chart showing the sequence of a mobile shelving installation from site examination to demonstration
Durations here are illustrative. The sequence is not: rail accuracy governs everything that follows.
1

Pre-installation conference and examination

On site, with the installer and owner. Room conditions, floor levelness, preparatory work by others, delivery route and working hours are all confirmed against the approved shop drawings.

2

Set-out and rail layout

Rail lines are marked from the drawings, squared to the room and to each other. This is where a room that is not square gets resolved deliberately rather than by accident.

3

Rail levelling and anchoring

Rails are levelled and shimmed or grouted as required, then anchored. On a recessed installation the pocket depth and grouting have to produce a rail flush with the finished floor.

4

Floor treatment and transitions

Where surface-mounted rail is used, the infill deck or ramping is completed so the aisle floor and the surrounding floor work together. Our rail comparison page covers the trade-offs in detail.

5

Carriages and squaring

Carriages are set on the rails, checked for square and free movement, and adjusted. A carriage that runs unevenly at this stage will not improve once it is loaded.

6

Shelving, panels and accessories

Uprights, shelves, end panels, handles, safety devices and any locking or access-control hardware are installed and adjusted.

7

Testing, adjustment and demonstration

Movement, safety devices and locking are tested and adjusted, then the system is demonstrated to the people who will operate it.

Loading is a separate exercise from installation, and it should be planned as one. Distribute the collection across the ranges in the order the layout intended, rather than filling the nearest ranges first — uneven loading is one of the most common reasons a new system feels harder to move than it did during the demonstration.

Illustration of a mobile shelving carriage wheel running on a rail set into a concrete floor
The rail is set into or onto structural floor construction and levelled across the run before anything is built above it.

Why the rail decision changes the installation

The single biggest variable in an installation is whether the rail is recessed into the slab or surface-mounted with an infill floor above it. Recessed rail produces a flush floor with no ramping, but requires saw-cutting or forming, accurate recess depths and grouting — work that has to be scheduled with the concrete or demolition trades. Surface-mounted rail avoids cutting the slab, but the finished aisle floor is built up on the rail deck, and the transition at the perimeter has to be handled.

That decision drives the sequence, the trades involved, the disruption to the surrounding area, and how the room reads when it is finished. It also interacts with anchorage: rails are anchored to structural floor construction, and in seismic regions the anchorage design is a specific engineering requirement rather than a hardware choice.

The full comparison is on our page covering recessed versus surface-mounted rail, and the anchorage requirements are covered on the seismic anchoring page.

What a proper handover includes

A system that moves smoothly on the day it is installed and is never adjusted again will be harder to move within a couple of years. Handover is where that is prevented, and it is worth writing into the purchase rather than hoping for it.

🔍

Testing and adjustment

Every carriage moved through its full travel under load, safety devices and locks tested, and adjustment carried out before sign-off — not a spot check on one range.

📘

Operation and safety demonstration

The people who will use the system shown how to operate it, what the safety devices do, how the locking works and what not to do. Include evening and weekend staff.

🔧

Maintenance expectations

A written statement of what to inspect and how often, what to clean and with what, and what needs a professional service visit.

📋

Documentation

As-installed layout, product data, warranty terms and the posted capacity information where the system or the room carries a rated load.

🚪

Access and keys

Locking hardware, keys or credentials handed over deliberately, with a record of who holds them, particularly on secured collections.

☎

A named contact

Who to call when a carriage starts to bind, and what the response looks like. This is the difference between a small adjustment and a large repair.

Completed compact mobile shelving installation with loaded shelving and an open aisle
A finished installation should move the same way at the far end of the run as it does at the near end.

Judge the handover on a loaded system

A demonstration on empty carriages tells you very little. Ask for the walkthrough after the collection is in, or at least after a representative range has been loaded, so that operating force, alignment and the behaviour of the safety devices are being shown under the conditions the system will actually live with. If something needs adjustment at that point, it is a normal part of commissioning rather than a warranty argument.

This is also the right moment to agree what “normal” feels like. Staff who know how a correctly adjusted carriage moves will notice a developing problem months before it becomes a repair.

The follow-through matters as much as the handover. Our page on preventive maintenance and service intervals covers what a realistic maintenance rhythm looks like once the system is in service.

Planning an installation date?

We install high-density mobile shelving across the Mountain West and can walk your site, survey the floor and tell you honestly what has to happen before an installation date is worth setting.

Request a Quote See the mobile shelving hub Call (800) 326-4403

The delays that show up again and again

Almost every avoidable delay on a compact storage installation belongs to one of a small number of categories. None of them are exotic; all of them are cheaper to prevent than to solve.

What goes wrong Why it happens How to prevent it
Floor out of tolerance The floor was never surveyed, or was surveyed only at a few points. Survey along the rail lines during design, against the manufacturer’s published tolerance.
Room not ready Finishing trades, particularly painting, are still working, or the room is still being used for storage. Specify that installation commences after finishing operations are complete, and confirm at the pre-installation conference.
Access route too small Component lengths were never checked against door widths, corridor turns or lift dimensions. Check the delivery route against actual component dimensions before the delivery is scheduled.
Structural review incomplete The floor-load question was deferred until submittals. Get the structural review done before the layout is committed. See our floor load page.
Services conflict above the ranges Sprinkler heads, light fittings or ductwork sit where the ranges or their full height need to be. Coordinate the services before the layout is fixed, and involve the fire protection engineer early.
Egress conflict The layout obstructs a required exit path when the aisle is open in a particular position. Verify egress against the layout in every aisle position, not just the drawn one.
Uneven loading after handover Material was loaded into whichever ranges were nearest. Plan the loading sequence with the layout, and check movement after the collection is in.

If you are installing into an occupied building rather than a new fit-out, the constraints are different again — phasing, dust, noise, working hours and keeping the collection accessible throughout. That situation is covered on our page about retrofitting mobile shelving into an existing building. If you are writing the specification, the specification and submittal checklist covers the sequencing and examination language directly, and the cost and budget drivers page explains where installation conditions show up in a price.

Related Boxes & Packaging Supplies

No online product listing covers the specified mobile-shelving system or installation work. These general boxes and shipping supplies are available from our store, but are not components of the mobile shelving system.

Installation questions we are asked

How long does a mobile shelving installation take?
It depends on the number of carriages, the rail approach, the drive type and site access, so any honest answer is specific to your configuration. What is more useful than a single number is the shape of the schedule: survey and structural review during design, manufacturing lead time, then a comparatively short and predictable on-site sequence, followed by loading. Ask your installer for a schedule that shows all of those phases.
Does the room have to be empty before installation?
Yes, in practice. The rail run has to be set out and levelled across the whole area, and carriages are assembled in place. Published mobile storage specifications also call for installation to begin after finishing operations, including painting, are complete. In an occupied building this is usually solved by phasing the room into sections.
Who is responsible if the floor is out of tolerance?
That should be agreed in writing before installation. The installer’s examination step is designed to identify the problem, but identification is not the same as ownership. Settle during procurement whether floor correction sits with the shelving supplier, the general contractor or the owner, and on what basis it is priced.
Can mobile shelving be installed on an upper floor?
Often, but only after a licensed structural engineer has reviewed the loaded configuration against the building’s actual capacity. Elevated construction concentrates load along the rail lines rather than spreading it evenly, so it has to be checked against the framing, not against an average pounds-per-square-foot figure.
Is the floor damaged when a system is installed?
It depends on the rail approach. Recessed rail involves cutting or forming a pocket in the slab and grouting the rail in. Surface-mounted rail is anchored to the slab and the aisle floor is built up over the rail deck, which involves anchors but no cutting. Both are permanent installations; plan them as such.
What should be tested before I sign off an installation?
Every carriage moved through its full travel, safety devices and locking tested, alignment and free movement confirmed, accessible aisle dimensions verified in the positions that matter, egress paths checked, and a demonstration given to the staff who will operate the system. Ask for the as-installed layout and any posted capacity information at the same time.

Get an installation assessed properly

Send us your room, your floor construction and your timing. We will tell you what has to be true before an installation date is set.

Headquartered in Salt Lake City, UT • Serving customers nationwide
Local service areas: Salt Lake City • Provo • Ogden • Park City • St. George • Logan • Lehi • Orem
