Modular Building on Top of a Mezzanine for an Air Force Base

An Air Force base needed more office, briefing and support space inside a building that had no floor area to give up. The answer was to build up: an engineered steel mezzanine over existing operations, with a finished modular building on the deck above. Here is how that kind of project is designed, permitted and installed.

Two-story modular building installed on top of a steel mezzanine platform with a blue stair tower inside a military maintenance hangar

125 PSF

Standard mezzanine live-load rating available

1/240

Maximum deflection under full live load

2–3x

Faster than comparable stick-built space

0 sq ft

Ground-level floor space given up

Why an Air Force Base Builds Up Instead of Out

Elevated modular office building set on a mezzanine deck above warehouse pallet racking
A modular office building assembled on a mezzanine deck above existing racking — the floor below stays in service.

Military maintenance buildings, hangars and supply warehouses are almost always short of two things at once: conditioned office space and floor area. Adding a wing means design, funding, sitework and a construction schedule measured in seasons. Taking a bay out of service to build offices means losing the space the building exists for.

Elevating the space solves both problems. A free-standing steel mezzanine is erected over aisles, racking or staging areas that are already there, and a modular building is assembled on the finished deck. Ground-level operations keep running underneath, and the new space arrives as pre-manufactured components that bolt together instead of as months of wet trades inside an occupied facility.

This page describes the approach and the engineering behind it. Project details, unit names and contract specifics are not published.

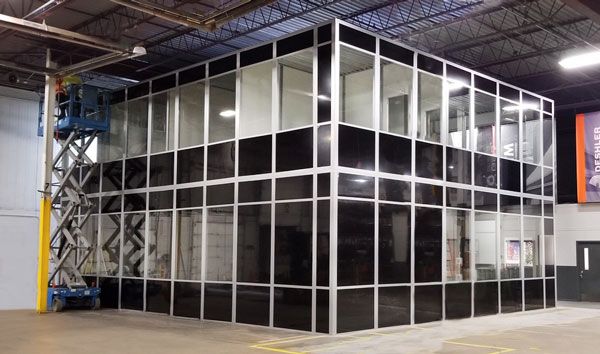

Two-story modular in-plant office elevated beside an assembly line with an exterior steel stairNo Ground-Level Footprint LostThe mezzanine columns sit in the aisles and racking bays you already own, so the new office, break room or training space is added above operations instead of taking a bay out of service. On a base where hangar and shop square footage is fixed, this is usually the only way to add conditioned space without a construction project.
Factory-built modular office module with panel walls, doors and windows staged before installationFaster Than Stick-BuiltWall panels, framing, doors, windows and the electrical package are manufactured off site while the slab work and mezzanine steel are being coordinated. Assembly is bolt-together, so installation is measured in days on site rather than months of wet trades in an occupied building.

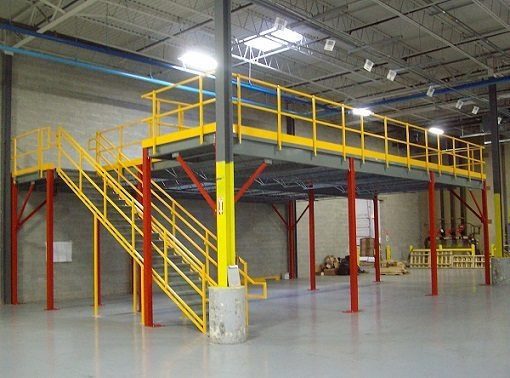

Newly installed steel mezzanine with yellow guardrail and stair inside an empty industrial bayEngineered, Stamped StructureThe mezzanine is a free-standing steel structure designed to a stated live load, deflection limit and clear height, with engineer-sealed drawings for permit review. It does not rely on existing walls or building columns for vertical support.
Finished interior of a modular in-plant office with drywall-look wall panels, acoustical ceiling grid and recessed lightingFinished Interior, Not a TrailerLaminated wall panels in vinyl, painted steel or FRP, acoustical ceiling grid, grid or surface-mounted lighting, 115V and 230V outlets, data jacks and through-wall or central HVAC — the upper level looks and performs like permanent office space.
Modular equipment enclosure with blue wall panels and yellow guard rail protecting the base of the structureReconfigurable and RelocatableBecause panels connect to extruded aluminum framing with connecting and corner posts, walls can be moved, extended or taken down and rebuilt elsewhere when the mission changes. Modular construction is often treated as equipment rather than permanent construction — confirm the classification with your resource advisor.
Modular machine enclosure with sound-proof wall panels, a personnel door and a wall-mounted HVAC unitCleaner, Quieter, ControlledThe same panel system builds sound-rated enclosures, dust-controlled rooms and modular cleanrooms, so an elevated platform can carry a calibration lab or an electronics repair room instead of only offices.

How an Elevated Modular Building Project Runs

The sequence matters more than any single component. Clear height and load are settled first, because everything above and below the deck depends on them.

1

Site & Load Review

We confirm clear height, slab thickness and slab reinforcement, sprinkler and lighting elevations, forklift routes and the loads the platform actually has to carry.

2

Layout & Engineering

Column grid, deck elevation, stair and gate locations and the office plan are drawn together, then sealed by a licensed engineer for permit submittal.

3

Off-Site Manufacturing

Mezzanine steel, decking, panels, doors, windows and the electrical package are built while site prep, permitting and base access are being coordinated.

4

Installation & Turnover

Steel goes up first, then decking, stairs and guardrail, then the building above. We hand over drawings, finish samples and warranty documentation.

Start with a clear-height and load review

Send us the building height, slab details and what you want on the platform. We will tell you whether the space works before anyone spends money on drawings.

Request a Quote Try the Modular Building Designer Call (800) 326-4403

The Mezzanine: The Part That Has to Be Right

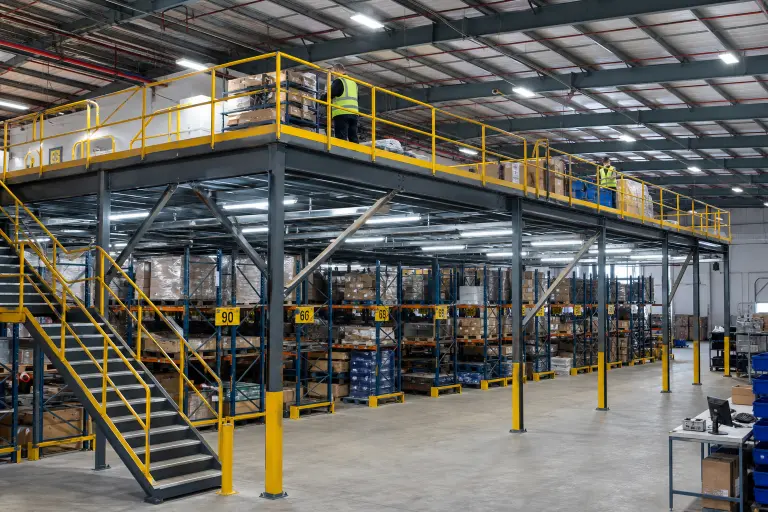

Free-standing structural steel mezzanine with guardrail and stair access ready for an elevated modular building
Free-standing steel mezzanine with guardrail and stair access before the building above is set.

A platform that will carry a building is not the same as a platform that will carry pallets. It is designed as a free-standing steel structure — it does not use existing walls or building columns for vertical support — with a stated design live load, a deflection limit and a defined clear height below and top-of-deck elevation above.

The specification we work from requires the manufacturer to state the design load in pounds per square foot, the deflection when live load is applied, the maximum column load, the shipping weight, the top-of-deck height and the minimum clear height below. Those six numbers are what a reviewer, a structural engineer and your own facilities group all need, and they are what separate an engineered platform from a shelf.

Columns land on base plates anchored to the slab per the sealed drawings, so slab thickness and reinforcement are checked at every column location before fabrication. Seismic forces are designed for the installation site, and the structure is designed to AISC, Steel Joist Institute, OSHA and the applicable building code.

Mezzanine parameter What we specify Source
Design live load Specified per project; 125 PSF is a common standard rating for storage and work-platform duty Panel Built structural steel mezzanines
Deflection limit Not more than 1/240 of span under full live load PBI mezzanine specification
Stairs and landings Designed for 100 PSF live load PBI mezzanine specification
Structure type Free-standing; does not use existing walls or building columns for vertical support PBI mezzanine specification
Columns Tubular steel columns on base plates anchored to the slab per the sealed drawings PBI / MH-USA tower and mezzanine specs
Decking options Steel form deck with plywood or resin-board finished surface, bar grating, or steel plate Panel Built mezzanine and CAD details
Bid information required Design load, deflection under live load, maximum column load, shipping weight, top-of-deck height and minimum clear height below PBI mezzanine specification
Referenced standards AISC, Steel Joist Institute, OSHA and the applicable building code; seismic forces per the installation site PBI mezzanine specification

Clear height is the first constraint, not the last

You are stacking four dimensions inside one building height: headroom under the deck, the deck and framing depth, the interior height of the building above, and its roof plus any rooftop HVAC. On a documented elevated in-plant office project the mezzanine provided roughly 151 inches of clear height below the deck — measure to the lowest obstruction, including sprinkler mains, ducts, lighting and crane rails, before assuming a two-level solution fits.

Section diagram of a multi-level mezzanine showing clear height below the deck and top-of-deck elevation
Clear height below the deck, framing depth and top-of-deck elevation all have to fit inside the existing building height.

The Building Above: Finished Space, Not a Shed

Modular panel-built room installed inside an industrial building with glazed walls and a personnel door
A modular panel building assembled inside an existing facility — the same system used on the elevated deck.

The structure on the deck is a modular panel building: laminated wall panels in an extruded aluminum frame, with real doors, glazing, ceilings, lighting, power, data and HVAC. Inside, it reads like permanent office space — painted or vinyl-finished walls, an acoustical ceiling grid, and lighting either surface-mounted or laid into the grid.

What makes it modular is how it comes apart. Panels attach to connecting and corner posts with ceiling caps and base plates, so a wall can be moved, a door relocated or a room added later without demolition. Two-story configurations, load-bearing roofs that carry a deck above the office, sound-rated rooms and cleanroom-grade enclosures all use the same panel system.

Because the panels, framing, doors, windows and the electrical package are manufactured while the platform steel and site work are being coordinated, the disruptive part of the project — work inside an occupied building — is compressed into a short, planned installation window.

Building component Specification
Wall panels 3-inch laminated core panels finished in vinyl, painted steel or FRP, in heights up to 15 feet
Framework Extruded aluminum alloy 6063-T5 with connecting posts, corner posts, ceiling caps and base plates so walls can be modified later
Doors Flush hollow metal doors with industrial-grade hardware; tempered, laminated or insulated glass options
Windows Fixed or sliding aluminum-framed units with factory-installed glazing
Roof and ceiling Corrugated steel B-deck or polystyrene-core panelized shed roofs; acoustical ceilings in a metal grid with optional fiberglass insulation
Electrical 115V and 230V outlets, data jacks and surface-mounted or grid lighting; UL-listed components
HVAC Through-wall or central HVAC with factory-framed wall cutouts
Scope Turnkey supply and install including electrical, fire suppression, HVAC and plumbing coordination
Submittals Shop drawings, floor plans and panel finish samples for approval before release

Comparing an elevated office to a conventional build-out?

We will price the mezzanine and the building above as one scope, including electrical, HVAC and fire suppression coordination, so you can compare it honestly against a stick-built alternative.

Request a Quote Modular vs. Conventional Build-Out Call (800) 326-4403

Codes, Egress and Fall Protection

An elevated occupied space is reviewed harder than a storage platform, and on a military installation it is reviewed by the base as well as the local authority having jurisdiction. These are the requirements that shape the design.

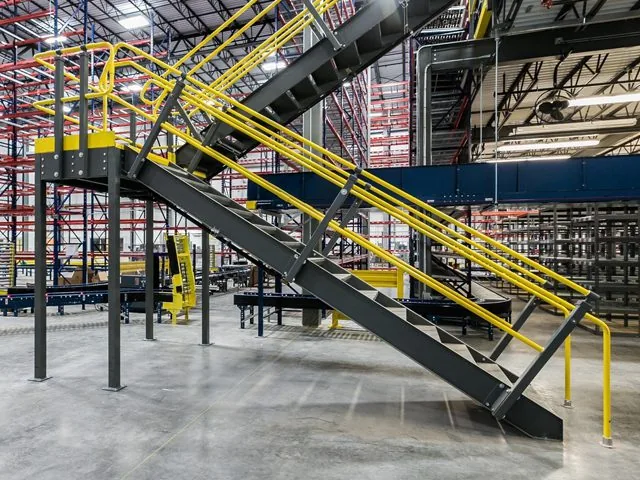

IBC-compliant welded steel mezzanine stair with handrails and closed risers serving an elevated platform
IBC-compliant steel stair with closed risers, handrails and guardrail serving the elevated level.
  • Mezzanine area is limited by code — the aggregate mezzanine area in a room may not exceed one-third of that room’s floor area under IBC 505.2.1, with specific exceptions
  • Means of egress from the mezzanine follows the egress chapter of the code (IBC 505.2.2); a second independent exit is required once the common path of egress travel is exceeded
  • Open-sided platforms 4 feet or more above the lower level need guardrails with a top rail at 42 inches, plus toe boards where material can fall (OSHA 1910.28 / 1910.29)
  • IBC stairs are typically 36 inches minimum width with a 7-inch closed riser and 11-inch tread, 42-inch guardrail and 34–38-inch handrails
  • Pallet drop and material-handling openings are protected with a rated safety gate, never an open gap
  • Sprinkler coverage, lighting, smoke detection and HVAC above and below the deck are reviewed with the base fire marshal before fabrication
  • Slab capacity under each column base plate is verified, and anchoring follows the sealed drawings and local code

What we will and will not promise

We supply engineer-sealed structural drawings, code-referenced details and submittal packages, and we design to IBC and OSHA requirements. We do not promise automatic approval or certification — the authority having jurisdiction and the base fire marshal make that determination, and we plan submittal time into the schedule accordingly.

What Goes on the Platform

Offices are the usual answer, but the same elevated approach carries anything that needs to be near operations without occupying the floor.

Two-story modular office installed by Material Handling USA with an interior stair and window wall on the upper levelMaintenance & Hangar OfficesSupervisor offices, planner desks and shift briefing rooms placed directly above the work they oversee, with a window wall looking down onto the maintenance floor.
Interior of a modular conference and break room with tables, seating, windows and a kitchenetteTraining & Briefing RoomsConditioned classroom space with acoustical ceilings and sound-rated walls, built above a shop bay so training does not compete with production for floor area.
Storage mezzanine built over a row of modular offices, using the platform above the office roofStorage Above, Offices BelowThe reverse configuration: a load-bearing roof deck over a row of modular offices turns the office roof into usable storage or a staging platform.
Modular cleanroom enclosure with white wall panels, flush ceiling and a sealed doorCalibration & Electronics RoomsElevated dust-controlled or ESD-conscious rooms for test, calibration and avionics work, with sealed panel joints and dedicated HVAC.
Elevated modular observation cab on a welded steel tower with a yellow stair and landing beside an airfieldObservation & Control CabsWhere the requirement is sightlines rather than square footage, the same modular approach builds an enclosed cab on a prefabricated tower or platform.
Ground-level modular office inside a warehouse with an exterior stair to a roof deckShipping, Receiving & Tool RoomsElevated offices over a receiving dock or tool crib keep the desk beside the transaction while leaving the ground floor open for carts, pallets and forklift traffic.

Working on Defense and Government Sites

Secure storage room at Hill Air Force Base built by Material Handling USA with shelving inside a wire mesh enclosure
Secure storage built by Material Handling USA at Hill Air Force Base — one of many defense-site projects.

Material Handling USA has been designing and installing storage and space systems for more than 30 years, including projects on Air Force, Navy and other government facilities — secure storage rooms and cages, high-density shelving, mezzanines, modular buildings, observation cabs and prefabricated towers.

What that experience actually buys you on a base project is process: submittals formatted for review, engineer-sealed drawings, delivery and escort coordination, installation crews that work around shift and flight-line schedules, and staging plans that keep aisles and exits clear while work is underway. The steel and the panels are the easy part.

We publish the engineering and the approach, not base-specific details. If you need references for comparable installations, we will provide them directly with the quote.

📝

Submittal-Ready Packages

Shop drawings, floor plans, panel finish samples and warranty documentation prepared for base and AHJ review before release to manufacturing.

🛠

Installation in Occupied Buildings

Sequenced steel, decking and panel installation with protected aisles, controlled work hours and coordinated delivery windows.

📏

One Responsible Party

Platform, stairs, guardrail, gates, the building above and the electrical, HVAC and fire suppression coordination all quoted and installed as a single scope.

Related Specification Summaries

Elevated projects usually pull from more than one product specification. These are the summaries most often referenced alongside a building-on-a-mezzanine scope.

Modular office with a load-bearing roof deck and stair access to the platform aboveIn-Plant Offices & Modular BuildingsTurnkey modular wall systems, rooms and enclosures: 3-inch laminated panels up to 15 feet, 6063-T5 aluminum framing, hollow metal doors, aluminum-framed windows, B-deck or panelized shed roofs, acoustical ceilings, 115V/230V electrical and through-wall or central HVAC.
Prefabricated modular observation tower with an enclosed cab on a welded steel support structure and stairPrefabricated Custom TowersFree-standing prefabricated towers assembled with standard tools, designed to meet or exceed AISC, SJI, OSHA and the applicable building code, supporting a 100 PSF live load with 1/240 maximum deflection, on 5″ tubular steel columns with powder-coated components and safety-yellow handrails.
Prefabricated steel shelter with glazed walls and a waterproof roof for exterior usePrefabricated Steel SheltersWelded ASTM A500 Grade B steel frame with epoxy primer and urethane coating, 96-inch standard height, waterproof roof with fascia trim and gutters, aluminum-framed windows with tempered, insulated or polycarbonate glazing, 30 PSF live load and 90 PSF wind load, mounted on a level concrete pad and anchored per local codes.

Submittals and approvals

Shop drawings, color charts, finish samples and warranty documentation are submitted for approval before manufacturing on every project. Electrical components are UL-listed. Ask for the full specification section when you are writing or reviewing a scope of work — call (800) 326-4403 or email Sales@MH-USA.com.

Project Planning Checklist

Two-story modular office in a warehouse with a yellow IBC stair and landing
Stair, landing and guardrail locations are planned with the column grid, not added afterwards.

Bring these items to the first conversation and a realistic budget and schedule can usually be put together in one pass instead of three.

  • Clear height available from slab to the lowest obstruction — joists, ducts, sprinkler mains, crane rails and lights
  • Required clear height under the deck for forklifts, carts and stock, and required headroom inside the building above
  • Live load the deck must carry, and any point loads from equipment, safes or file systems
  • Column locations that keep aisles, racking bays and fire exits clear
  • Stair and landing location, plus a second exit path if the occupant load or travel distance requires one
  • How material gets up: stair only, pallet drop with a safety gate, vertical reciprocating conveyor or lift
  • Power, data, lighting, HVAC and fire suppression routing to the elevated level
  • Base-specific requirements: escorts, badging, work hours, sprinkler shutdown procedures and submittal review time

Send us your building, we will send you a layout

A dimensioned sketch or photo of the bay, the clear height to the lowest obstruction and what you want on the platform is enough to start. We will come back with a layout and a budget number.

Request a Quote Design Tools Call (800) 326-4403

Modular Building on a Mezzanine FAQs

Can you really put a modular building on top of a mezzanine?
Yes — it is one of the most common ways to add conditioned space inside an existing building. The mezzanine is engineered for the loads of the structure above it plus the occupancy and equipment loads, and the building is assembled on the finished deck. The key is designing the platform and the building together, not adding a building to a platform that was only sized for storage.
How much load will the mezzanine carry?
The design live load is specified per project. A 125 PSF live-load rating is a common standard for storage and work-platform duty, and deflection is limited to 1/240 of span under full live load. Stairs and landings are designed for 100 PSF. Point loads from equipment or heavy filing are called out separately so the framing under them can be adjusted.
How much clear height do I need?
You need the height under the deck for whatever passes below, the deck and framing depth itself, and the interior height of the building above plus its roof and any HVAC. On real projects an elevated in-plant office has been built with roughly 151 inches of clear height below the platform, so the clear-height study should come before anything else in the design.
Is it code compliant?
It is designed to be. Mezzanines are governed by IBC 505 — including the one-third area limitation and the egress requirements — with guardrails, stairs and fall protection per the code and OSHA 1910.28 and 1910.29. We supply engineer-sealed drawings for permit and base review. We do not promise automatic approval; the authority having jurisdiction always makes that call.
Can the structure be relocated later?
Yes. Both the platform and the building are bolt-together assemblies. Panels connect to aluminum framing with removable posts and caps, so walls can be reconfigured, extended, or disassembled and rebuilt in another building. That flexibility is a large part of why modular is chosen on bases where missions and tenants change.
What is the lead time?
It depends on size, finishes and the electrical and HVAC scope, and on how quickly submittals are reviewed. Because manufacturing happens while site prep, permits and base access are being arranged, the on-site portion is normally the shortest part of the schedule. We give a firm schedule with the quote once the drawings are approved.
Do you handle installation on a secure site?
Yes. We coordinate delivery windows, escorts and badging with the facility, work around shift and flight-line schedules, and stage material so aisles and exits stay clear. Installation crews work off the approved drawings and hand over as-built documentation at turnover.
What documentation do we get?
Engineer-sealed structural drawings, floor plans, panel finish and color samples, UL-listed electrical component information and warranty documentation. Shop drawings and finishes are submitted for approval before anything is released to manufacturing.

Need Space You Do Not Have Floor Area For?

Tell us the building height, the slab, and what belongs on the platform. We will design the mezzanine and the modular building above it as one engineered, permit-ready scope.
