Cantilever Rack Installation in Utah: Permits, Anchoring, Assembly and Inspection

What actually happens when cantilever rack goes in along the Wasatch Front: engineering and city permits, slab and anchor checks, the assembly order, bracing, first loading and the inspections that keep a row safe.

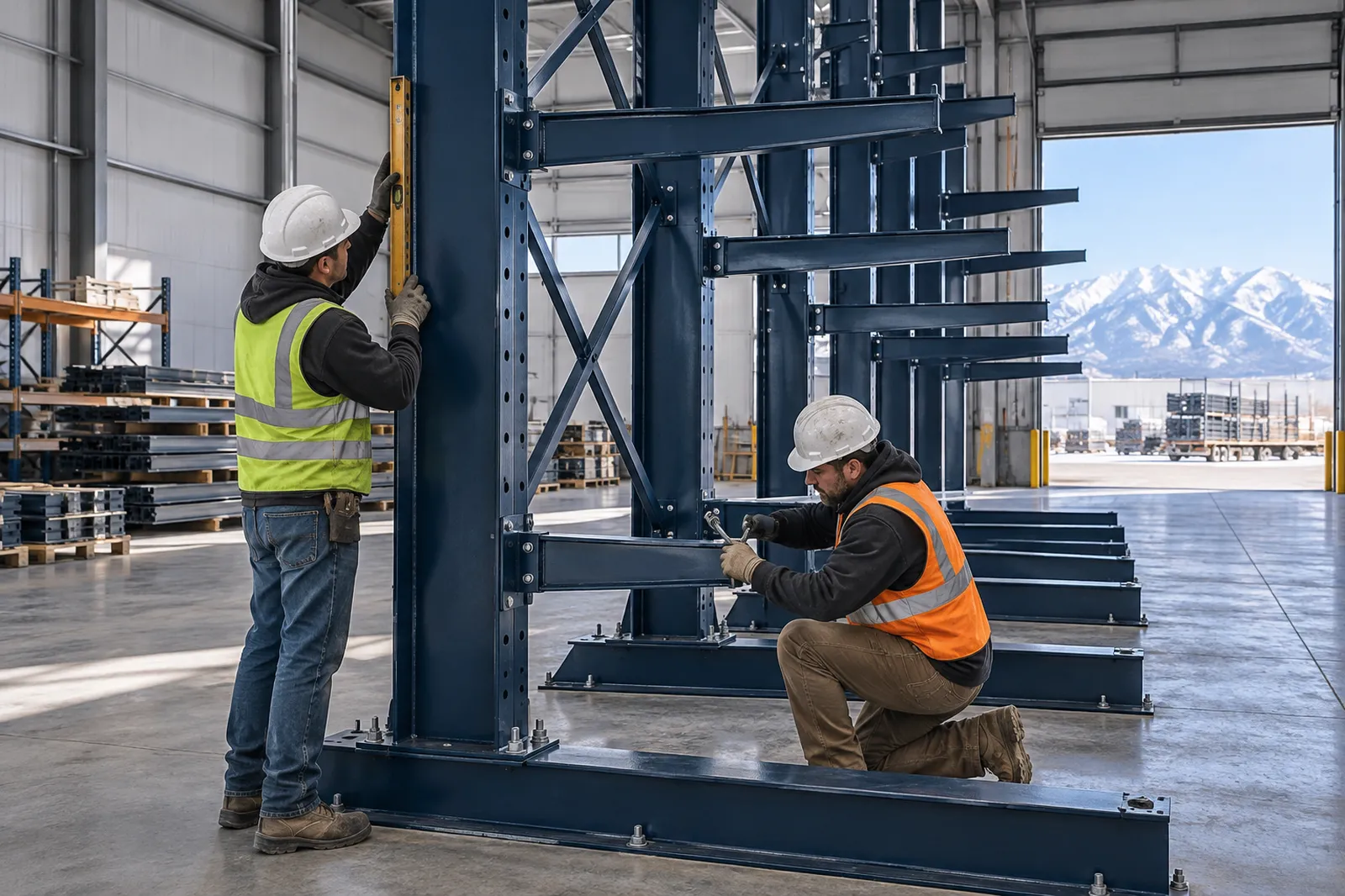

Installers checking a structural cantilever rack column for plumb and bolting an arm in a Utah warehouse

Permit first

Installers scheduled after approval

Braces + horizontals

Required to stand a row

Concrete only

No anchoring into asphalt

Annual minimum

RMI inspection interval

What Cantilever Rack Installation Involves

Cantilever rack looks simple: a row of columns standing on base legs, arms bolted to the columns, and bracing tying the columns together. That simplicity is exactly why installations go wrong. There is no front upright to hold anything in place, so every pound on an arm is carried back through the column, into the base and down into the floor. A column that is out of plumb, a base sitting on a soft spot, or a missing brace does not show up until the row is loaded.

This guide walks through a real installation in the order it happens, using what we see on projects across Salt Lake City, Ogden, Provo and the rest of the state. It covers the paperwork that comes before the truck, the floor under the rack, the assembly sequence, outdoor yards and the inspections after handover. If you are still choosing a system, start with our cantilever rack supply and installation page for Salt Lake City and Utah, or compare configurations on the main cantilever rack systems page.

Cantilever rack columns and arms being installed in a warehouse
📋

Paperwork first

Engineering, permit and a complete parts list before anyone unloads steel.

🧱

Floor second

Concrete that can hold the anchors, level enough to plumb the columns.

🔧

Assembly third

Bases, columns and bracing as a stable frame, then arms, then loading.

Before the Truck Arrives: The Parts List Check

The most common delay on a cantilever install is not a hard problem. It is a missing part. Cantilever is sold as separate components, and the component list has to match the configuration exactly. Two lessons come up again and again on our jobs:

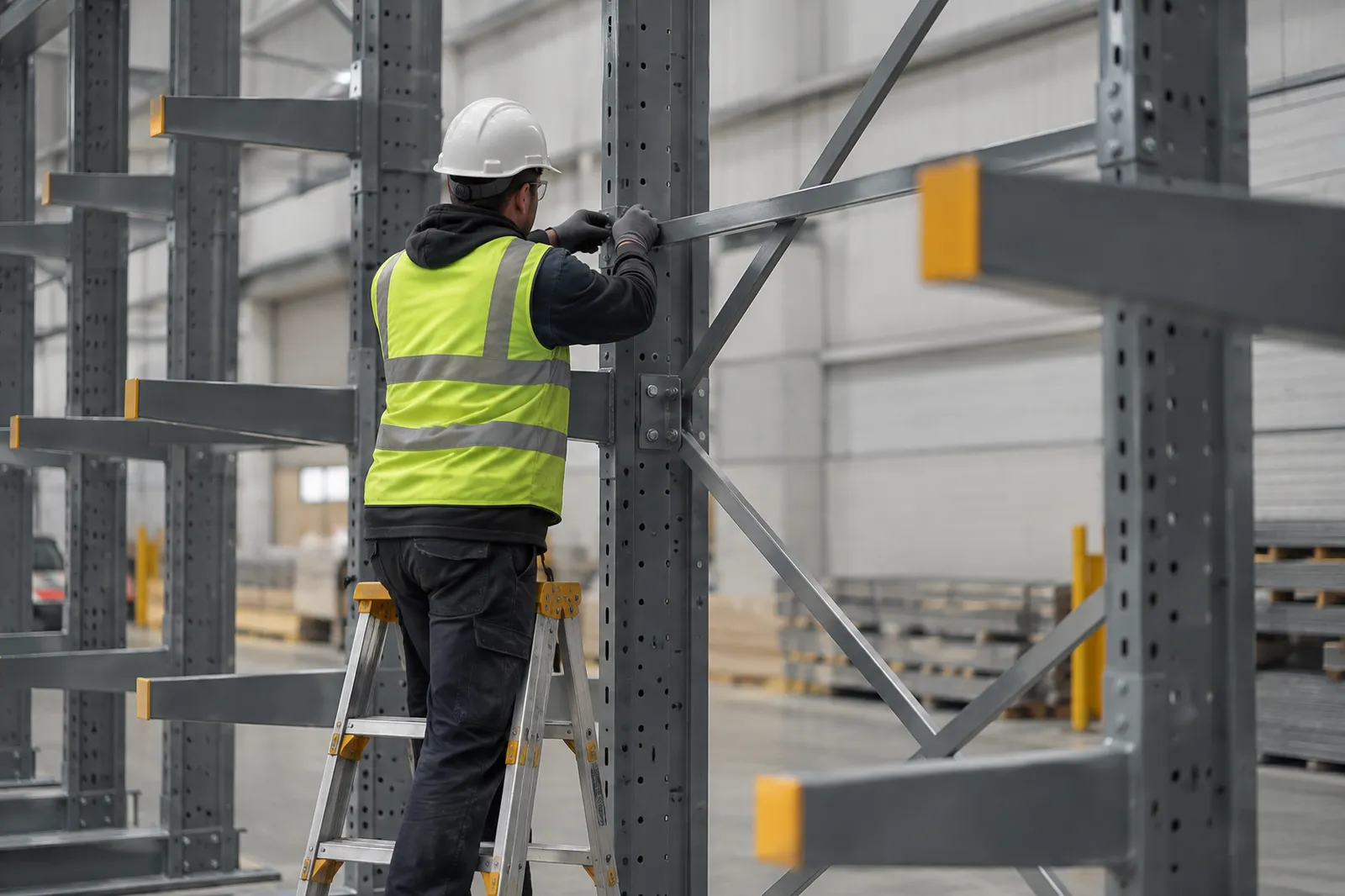

Installer bolting X-bracing and a horizontal brace between two cantilever rack columns

Bracing comes in two pieces. Manufacturers typically sell X-bracing and horizontal braces as separate line items, and they do not know how many horizontals your layout needs unless the order spells it out. A row cannot be stood up safely without both, so a short count on horizontals stops the crew on day one. Count one brace set per bay between columns, and confirm the horizontals per bay with your supplier.

Assembly hardware is not anchor hardware. A cantilever hardware kit usually includes the bolts that join bases, columns, arms and braces, but not the anchor bolts that tie the bases to the floor. Anchors are chosen for the actual slab or footing, so they are quoted separately. Make sure someone owns them before install day.

Component What to confirm before delivery
Columns Height, quantity, single- or double-sided; matching the drawing
Bases One per column, length matched to arm length; double-sided bases for double-sided columns
Arms Length, quantity per column, straight or inclined, rated capacity at that length
X-bracing One set per bay, sized to the column spacing on the drawing
Horizontal braces Quantity per bay confirmed with the supplier; ordered as a separate line
Assembly hardware Bolts, nuts and locking pins for every connection
Anchors Type and length suited to the slab or footing; quoted separately
Accessories Pipe stops, end stops or decking if the load needs them

Receiving tip

Have a forklift or enough labor ready, check the bundle count against the packing list, and note any damage on the delivery receipt before the driver leaves. Bent arms or columns should never be installed.

Engineering, Permits and Seismic Design in Utah

Utah builds to a statewide construction code based on the International Building Code (IBC), with state amendments. The IBC’s steel chapter sends cantilevered steel storage racks to ANSI MH16.3, the Rack Manufacturers Institute specification for cantilever rack, and, where ASCE 7 requires it, to the seismic provisions for steel storage racks in ASCE 7 Section 15.5.3. In plain terms: a permanent cantilever installation is treated as an engineered structure.

Seismic design is not a formality here. The U.S. Geological Survey’s earthquake forecast for the Wasatch Front puts the probability of one or more magnitude 6.75 or larger earthquakes in the region at 43 percent over the next 50 years. The rack engineer accounts for that in column size, base length, bracing and, above all, anchorage.

On our Utah projects the sequence is consistent. A rack engineering firm prepares calculations and drawings for each distinct configuration in the layout, so a row with two different arm lengths or column heights may need two sets. The customer or contractor submits them to the city or county, and the installers are scheduled once the permit is issued. Afterward, the permit stays open until the building department completes a final inspection, so leave room for that visit on the schedule.

Cantilever rack load planning with arms and columns sized for stored material
1

Layout and parts list

Configuration, column heights, arm lengths and loads are fixed on a drawing.

2

Rack engineering

Calculations and drawings for each configuration, including anchorage.

3

Permit submittal

The city or county reviews the package; requirements vary by jurisdiction.

4

Installation

Crews are scheduled after the permit is issued.

5

Final inspection

The building department inspects and closes the permit.

Moving an existing row counts too. When a customer relocated permitted rack to a neighboring building, our advice was to check with the city first, because the city may want new engineering or a separate permit for the new location. Our rack relocation, teardown and reinstall page covers that process in detail. Requirements differ between Salt Lake City, Ogden, Provo, St. George and county jurisdictions, so always confirm with the local building department before work starts.

The Floor: Slab, Anchors and What Not to Anchor Into

Every cantilever base is designed to be anchored. The anchors resist the overturning pull that a loaded arm creates, and in a seismic region they also hold the row against lateral shaking. That makes the floor part of the structure.

Indoors, the question is whether the slab can develop the anchor capacity the engineer specifies. Thickness, concrete strength, cracks, joints and edge distance all matter. If the slab is thin or unknown, the engineer may call for a different anchor or a thickened section under the bases. Where the slab is out of level, bases are shimmed with steel shims so the columns stand plumb, never by bending or forcing a column.

Outdoors, we do not recommend anchoring cantilever to asphalt. Asphalt is a flexible material that softens in warm weather, so it cannot hold an anchor reliably. Gravel cannot hold one at all. Yard rows need concrete: either a designed slab or footings under each base. The Big Yeti Builders yard project in Ogden shows how footing size was worked out from base length and column spacing.

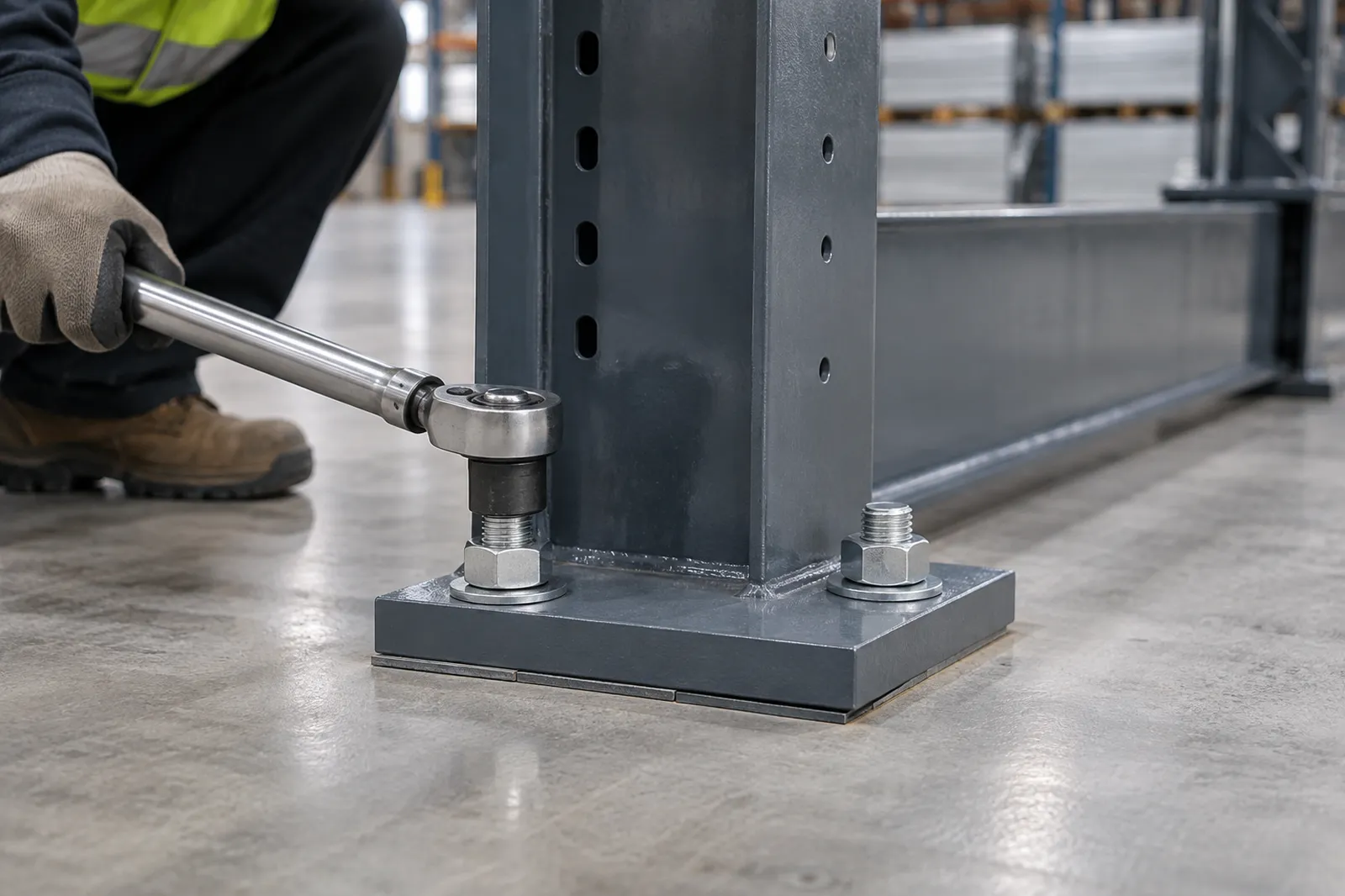

Cantilever rack base plate anchored to a concrete slab with wedge anchors, shims and a torque wrench
Surface Suitable for anchoring? What usually happens
Sound concrete slab Yes, when it meets the engineer’s requirements Anchors installed per the drawings, bases shimmed level
Thin or cracked slab Only after review Different anchors, relocated bases or a thickened section
Asphalt No Concrete footings or a slab are added under the bases
Gravel or compacted fill No Concrete footings designed for the soil and frost depth

The Assembly Order, Step by Step

Always follow the manufacturer’s installation instructions and the stamped drawings for your specific system; they govern bolt sizes, torque and tolerances. The general sequence below is how a typical row goes up, and why the order matters.

1

Mark the layout

Snap lines for the row and mark each column location from the drawing, checking clearances to doors, sprinklers, dock traffic and walls.

2

Attach bases to columns

Bolt each base to its column on the floor, with the base pointing the way the arms will project (both ways on double-sided).

3

Stand the first two columns

Raise the first pair with suitable lifting equipment and hold them until they are tied together.

4

Brace the first bay

Install the X-bracing and horizontal braces between the pair. This creates the first stable frame.

5

Plumb, shim and anchor

Check each column for plumb in both directions, shim the bases as needed, then install the anchors.

6

Work down the row

Stand, brace, plumb and anchor one column at a time, never leaving a column freestanding.

7

Hang the arms

Install arms at the heights on the drawing, working from the bottom up, with every bolt or locking pin fully engaged.

8

Accessories and final check

Add pipe stops or end stops, re-check plumb and connections, and post the load capacity.

Double-sided cantilever rack with arms on both faces of the columns

Structural versus roll-formed. Structural cantilever uses hot-rolled I-beam columns with bolted arm connections and is the usual choice for heavy steel, pipe and outdoor yards. Roll-formed (medium-duty) systems use lighter columns and arms that typically engage the column and lock with a pin or bolt. Both install in the same order, but roll-formed arms must be fully seated and locked, because an arm that is not engaged can be lifted out by a forklift tine. Our Merchants Metals project explains why that branch chose structural.

Single-sided versus double-sided. Single-sided rows usually run along a wall or fence line with bases pointing away from the aisle; double-sided rows stand freestanding with bases in both directions and need two working aisles. Double-sided columns can be armed on one face first and expanded later, as at Western Timber Frame.

Installing Cantilever in a Utah Yard

A large share of Utah cantilever lives outside: lumber and building-materials yards, fence and pipe suppliers, contractors and ag operations. Outdoor installation adds a few items to the checklist.

  • Snow, wind and hail. The Rack Manufacturers Institute notes that designers of outdoor cantilever factor in extreme snow, wind and hail when sizing members. Snow that collects on stored bundles is weight on the arms, so tell the engineer where the rack will stand.
  • Finish. Galvanized or outdoor-rated finishes resist rust through freeze-thaw cycles better than standard indoor paint.
  • Footings and frost. Footings are poured, cured and level before the crew arrives, designed for local soils and frost depth.
  • Traffic. Yard loaders and forklifts move fast; plan aisle widths and protect column ends and base legs at drive aisles.

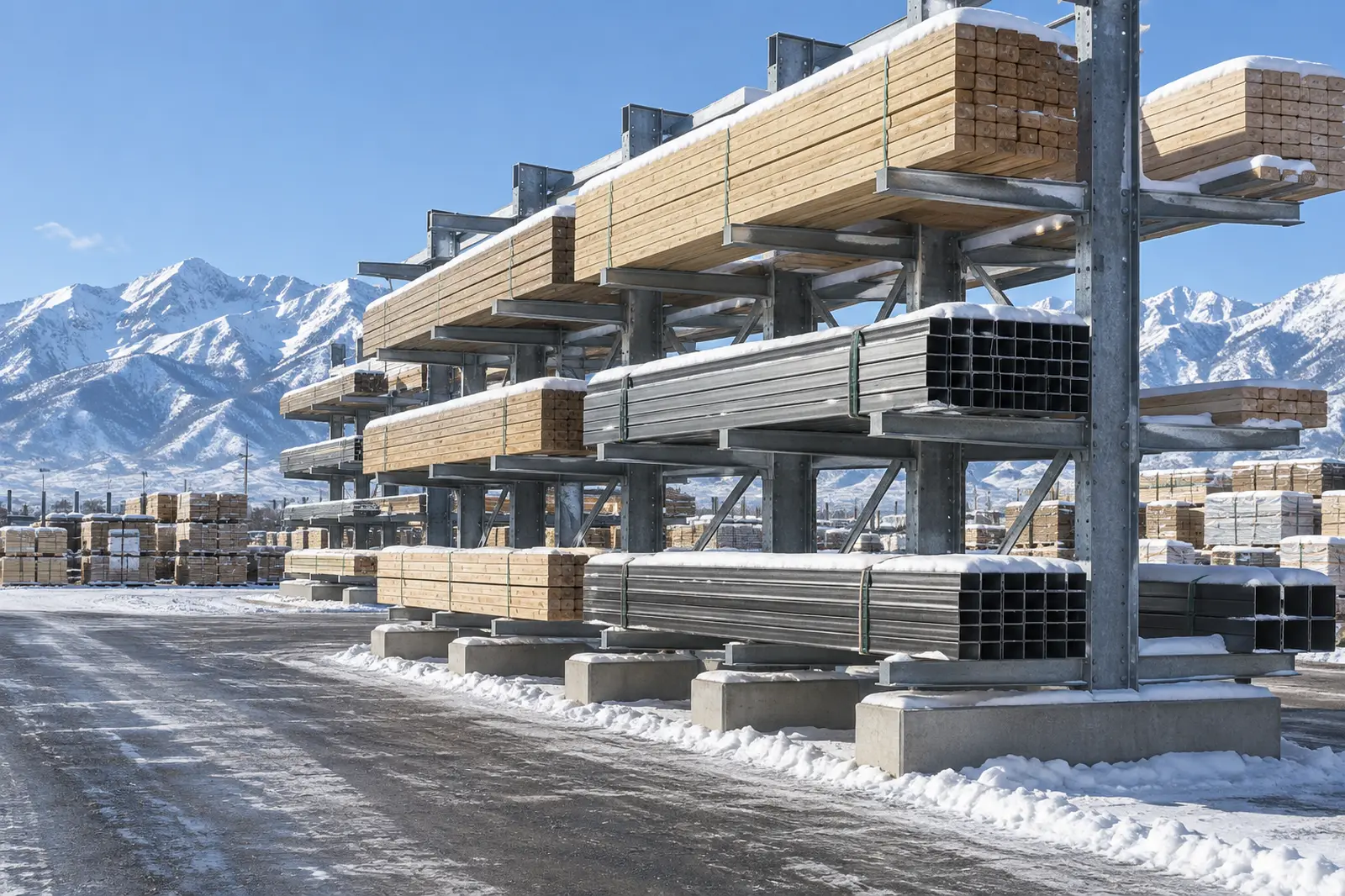

Galvanized double-sided cantilever rack on concrete footings in a snowy Utah building-supply yard

Covered outdoor storage is also possible. ANSI MH16.3 covers cantilever racks with accessories such as shed roofs and canopies, but a roof adds its own snow and wind loads, so it must be part of the engineered design rather than added afterward.

Handover and First Loading

Single-sided cantilever rack along a wall with long material on the arms

Installation is not finished until the row is loaded correctly. A few rules keep a new row within its design:

  • Keep every arm under its rated capacity at its length, and make sure the column and base ratings cover all the loaded arms above them. Our guide to cantilever load capacity by arm length walks through the math.
  • Rest long loads on enough arms that they do not sag or overhang excessively between them.
  • Place loads gently. RMI’s guidance notes that ANSI MH16.3 designs arm connections for an added impact of 25 percent of the handled load, up or down, and rough placement can still dislodge an arm.
  • Load double-sided rows reasonably evenly on both faces, and keep the heaviest material low.
  • Watch the arm tips when traveling down the aisle; with no front upright, they are exposed.

Inspection After Installation

RMI’s best practices for cantilevered storage rack call for inspections at least annually, and more often for high-traffic or previously damaged rack. ANSI MH16.3 also recommends inspecting anchor bolts at installation and periodically afterward, because the anchors are part of the system that resists overturning. Federal rules add a general requirement: under OSHA 29 CFR 1910.176(b), stored material must be stable and secure against sliding or collapse.

  • Columns plumb, with no dents, bends or twists
  • Anchors present and tight; base plates flat on the floor or footing
  • Every arm bolt or locking pin in place; no bent or tipped arms
  • X-bracing and horizontal braces present, straight and bolted
  • Load signs posted and loads within rated capacity
  • Outdoor rows: rust, footing cracks and settlement after the first winter

If you find damage, isolate the rack, unload it when it is safe to do so, and keep it out of service until the damaged parts are repaired or replaced.

Cantilever rack components inspected for wear and damage

Customer Install or Full-Service Install?

Both work, and we do both. Some customers take material-only delivery and install with their own crews, like the OrePac building-materials yard in Boise and the Merchants Metals branch in Murray. Others want the whole job handled: engineering support, permit documents, delivery and a professional crew, as with the Ogden yard project above. If your team installs, ask for the manufacturer’s instructions and the stamped drawings with the order, and plan the anchors and lifting equipment in advance. To sketch a layout before calling, try our cantilever rack designer. For warehouse racking beyond cantilever, see Utah pallet rack and the full pallet rack range.

Customer install Full-service install
Engineering and drawings Provided with the order when required Coordinated for you
Permit Customer or contractor submits We support the submittal package
Anchors Customer sources to the drawings Included in the install scope
Crew and equipment Customer Professional installation crew
Best for Small rows, experienced in-house teams Large rows, yards, seismic-engineered jobs
Cantilever rack row holding long material on multiple arm levelsCantilever Rack in Salt Lake CitySupply, delivery and installation along the Wasatch Front.

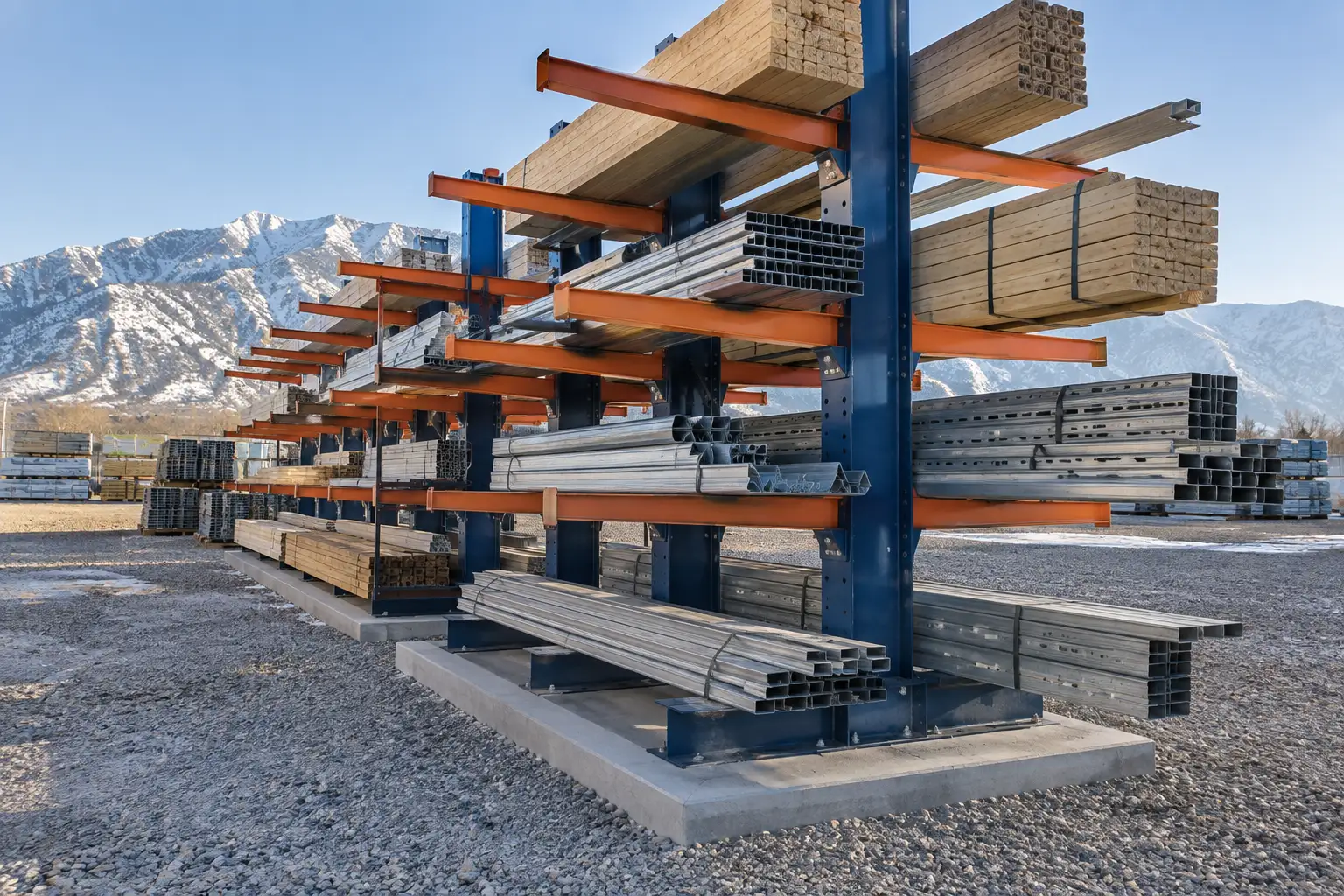

Double-sided cantilever rack on concrete footings in an Ogden contractor yardOutdoor Yard Case Study, OgdenFooting sizing and a double-sided yard row, installed.

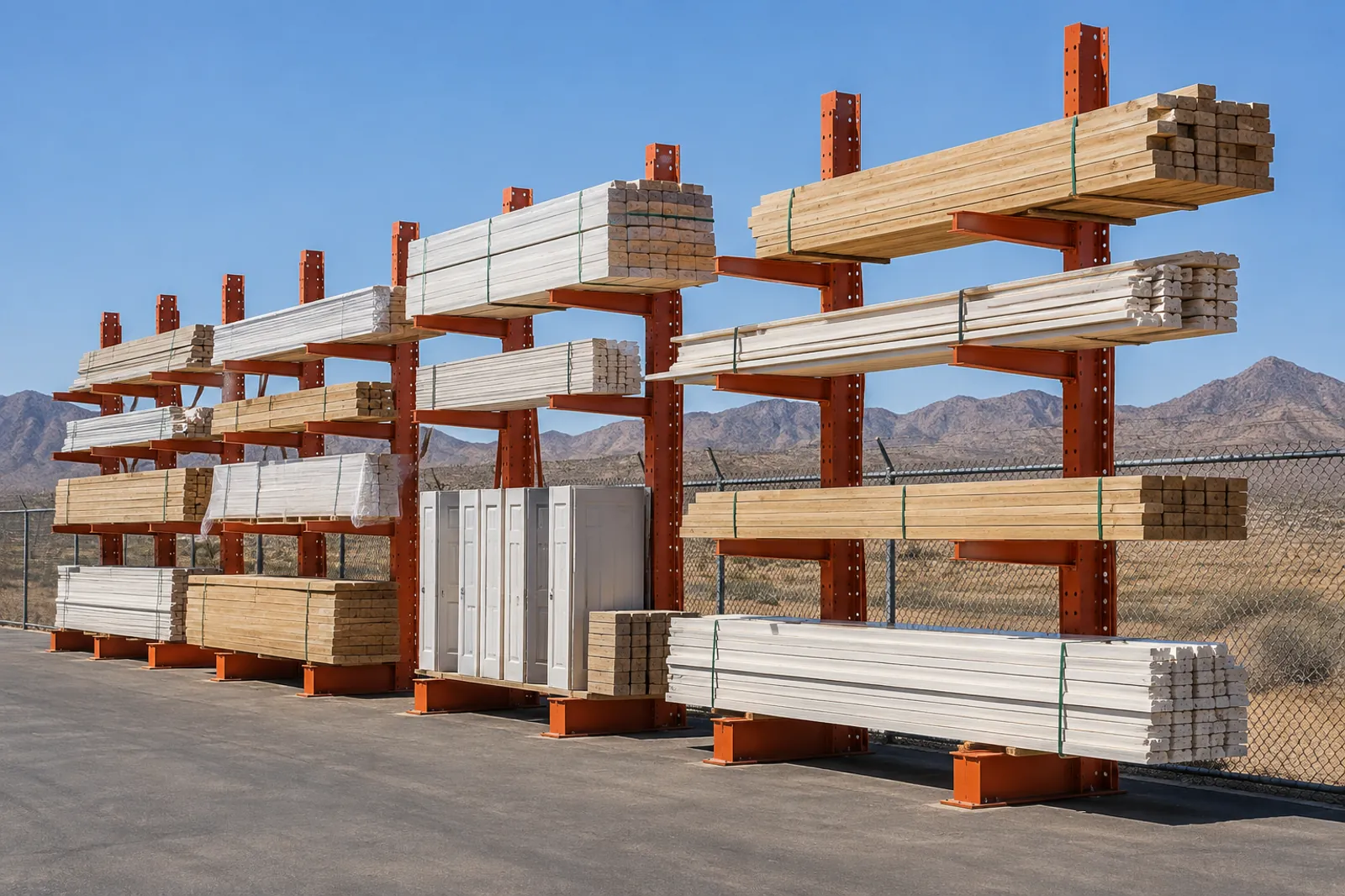

Single-sided cantilever rack in a building materials yardCustomer-Installed Yard Row, BoiseMaterial-only supply and why asphalt was not an anchor surface.

Cantilever Rack Installation FAQs

Do I need a permit to install cantilever rack in Utah?
Often, yes. Utah uses a statewide code based on the IBC, which treats cantilever steel storage racks as engineered structures under ANSI MH16.3 and, where required, ASCE 7 seismic provisions. Most permanent installations are permitted with engineering, but requirements vary by city and county, so check with your local building department before installation.
What comes with a cantilever rack order, and what does not?
Columns, bases, arms, bracing and assembly hardware are ordered to the configuration. Anchor bolts are usually quoted separately because they depend on the slab or footing, and horizontal braces are often a separate line from the X-bracing. Confirm both before install day.
Can cantilever rack be anchored to asphalt?
We do not recommend it. Asphalt is flexible and softens in warm weather, so it cannot hold anchors reliably. Outdoor rows should stand on a concrete slab or concrete footings.
In what order is cantilever rack assembled?
Bases are bolted to columns, the first two columns are stood and braced together, then each column is plumbed, shimmed and anchored before the next one goes up. Arms are hung last, from the bottom up, and every connection is re-checked before loading. Always follow the manufacturer’s instructions and drawings.
How often should cantilever rack be inspected?
RMI recommends at least annual inspections, more often in high-traffic areas or after damage. Check anchors, base plates, columns, bracing, arms and connections, and inspect outdoor rows after the first winter.
Can we install cantilever rack ourselves?
Yes, many customers do, especially for smaller rows. Get the manufacturer’s instructions and any required stamped drawings, use proper lifting equipment, and never leave a column standing unbraced. For large rows, yards or seismic-engineered jobs, a professional crew is usually faster and safer.
Does Material Handling USA install cantilever rack across Utah?
Yes. We supply and install cantilever rack along the Wasatch Front and throughout Utah, and we also ship material for customer installation. Call 801-328-8788 to talk through your project.
